Salal(503) 555-0147
Sheet
L-1.2
Subject
Build
Locality
Portland metro
Scale
Own crews

Most of the money goes into things you will never see again.

Drainage, subgrade, soil. By the time a garden is finished, roughly half of what you paid for is buried, and it is the half that decides whether the other half is still alive in ten years.

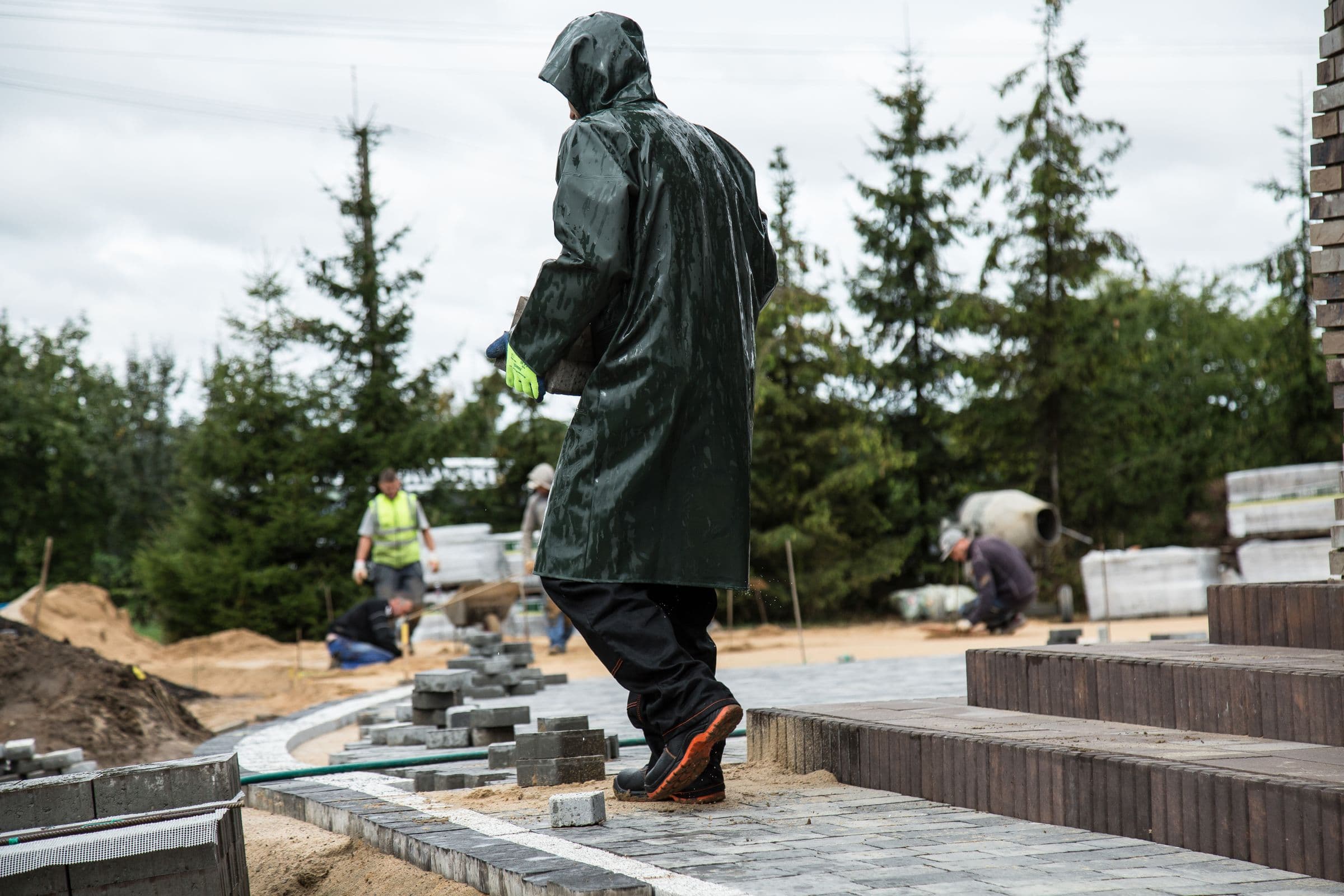

A worker in a full-length dark rain cape walking across a partly finished paved area, with two more of the crew working further back beside a sand pile and a row of young conifers under a grey sky.
Three people, one job, in the weather this region actually has.

Grading and drainage come first, and they are not negotiable.

Nothing else can be done until water has somewhere to go. On a Portland job that usually means establishing falls across the site, cutting drain runs to a real outfall, and — where there is no outfall — building somewhere for the water to soak away that will still work in its twentieth winter.

A perforated pipe surrounded by clean drain rock in a trench wrapped with geotextile is a drain. A perforated pipe laid straight into clay with soil backfilled on top is a pipe full of silt within three years, and we have dug up a great many of them.

Where a rain garden is the right answer, it is often also the cheaper one, and in Portland it may qualify the property for the city’s stormwater utility discount for managing roof water on site. Worth asking about before you dig, not after.

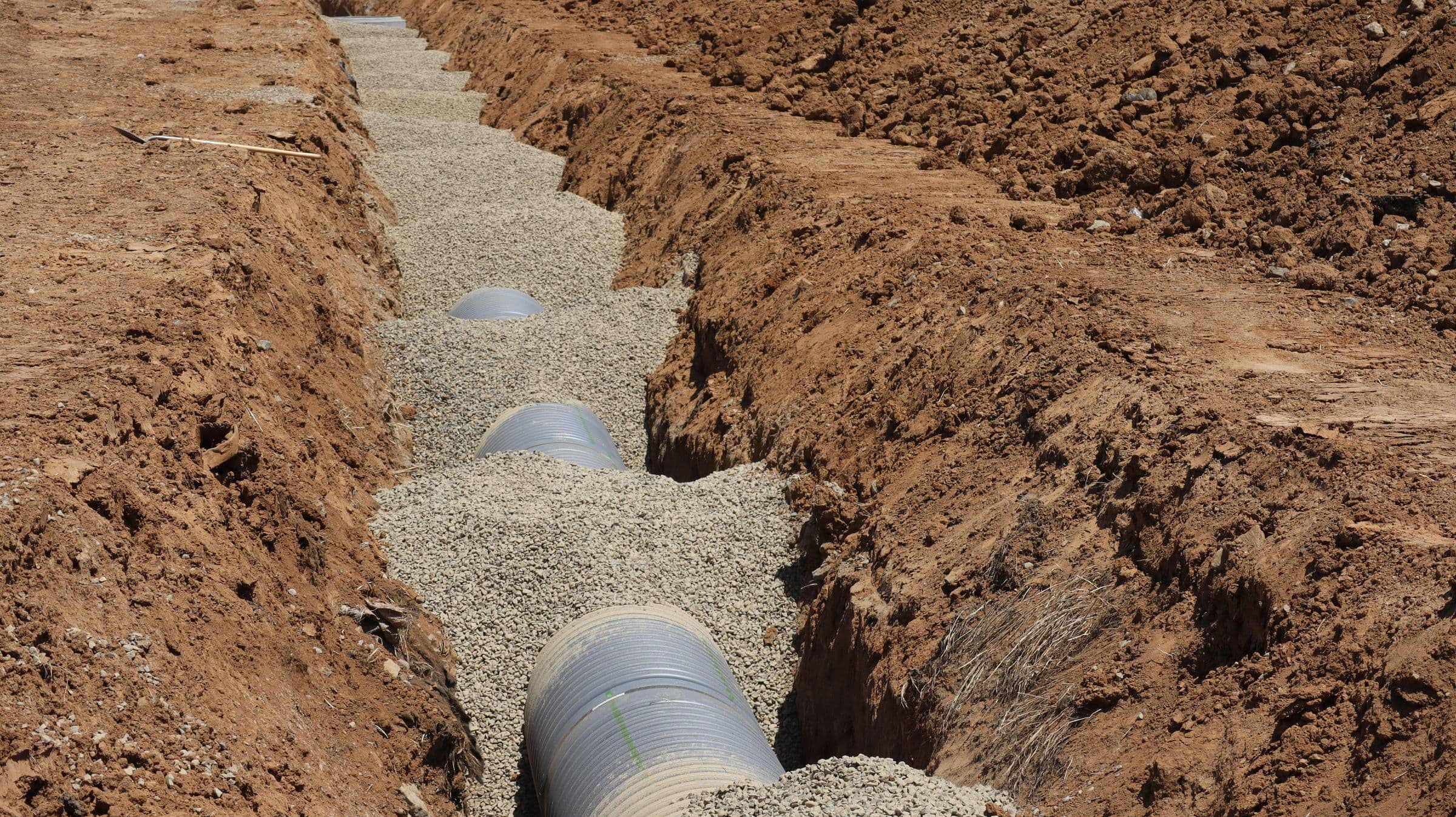

A perforated corrugated drainage pipe laid along the bottom of a trench in reddish clay soil and surrounded by clean pale drainage gravel, running away from the camera.
Perforated pipe in clean drain rock. The rock is the drain; the pipe only carries away what the rock collects.

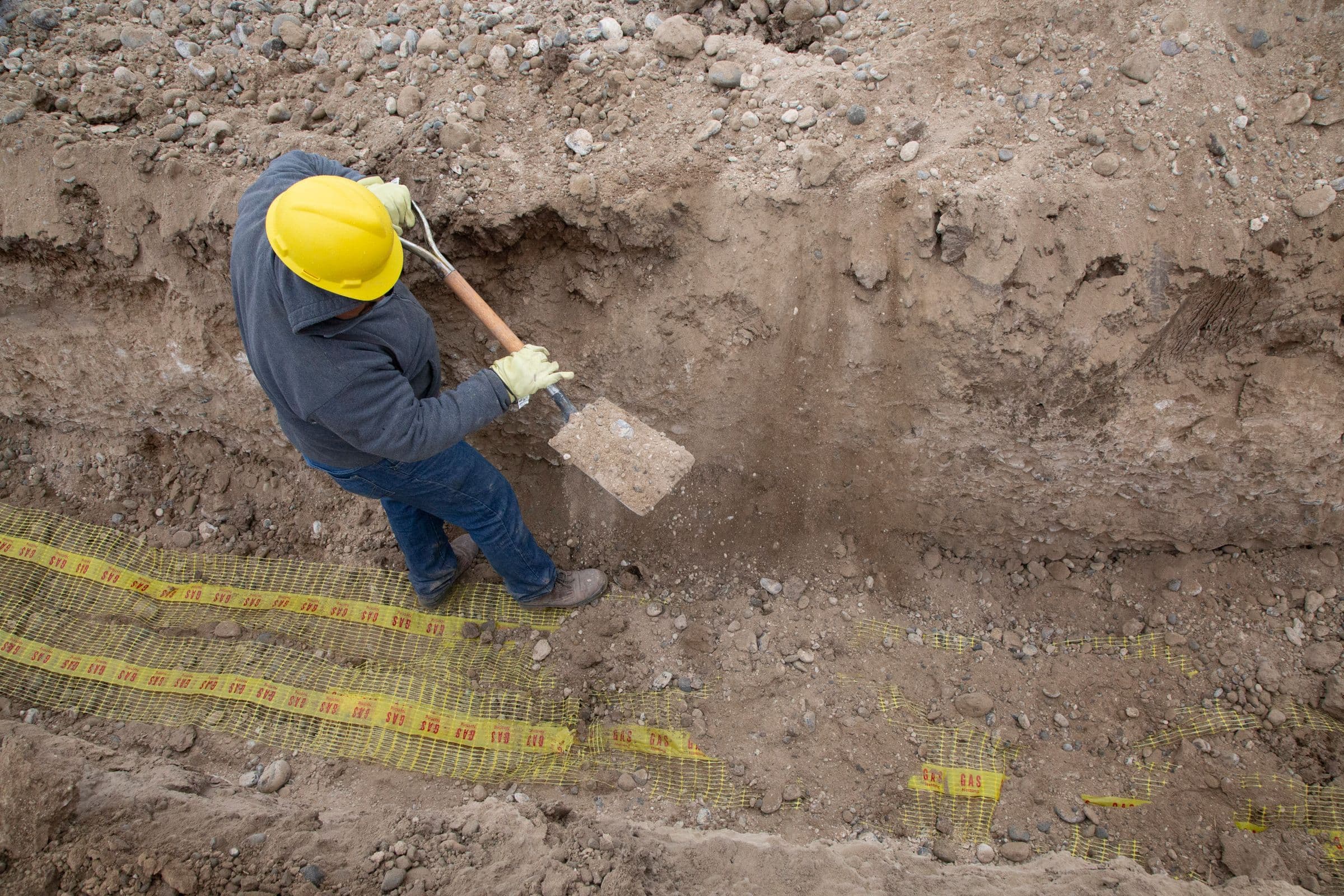

Looking down on a worker in a yellow hard hat standing in a narrow trench, driving a spade into the exposed soil wall, with survey tape running along the ground above.
The last of a drain run goes in by hand. A bucket cannot tell the difference between a root and a rock.

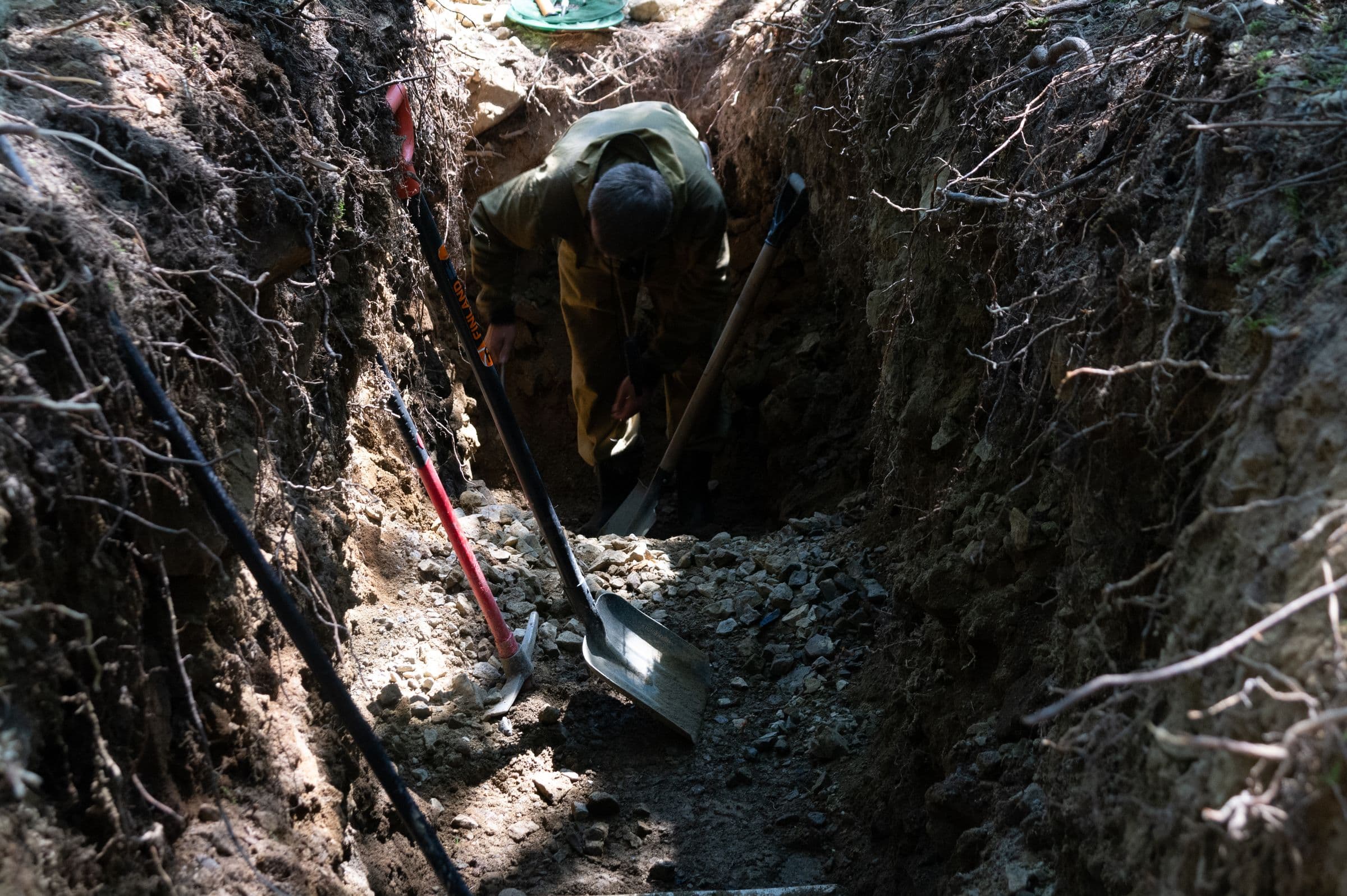

A deep narrow trench cut through dark soil with severed pale roots visible in its walls, a shovel and a pick lying across the top.
Roots cut clean in a trench wall. Every one of them was a decision made before the trench was set out.

Soil preparation is the invisible half of the budget.

This is the line clients try to cut and the line we will not reduce. It is somewhere between eighteen and thirty per cent of a build, it takes two days, and at the end of it the garden looks exactly the same as it did at the start.

What it involves: ripping the subgrade to eighteen inches so there is no boundary for a root to stop at, then incorporating compost through the top eight to twelve inches rather than laying it on as a blanket. On a typical Portland back garden that is two to three hundred cubic yards of material moved for a result that photographs as brown.

We do not add fertiliser at planting and we do not use soil conditioners in bottles. Compost, and enough of it, in ground that has been broken up first. That is the whole method and it has not changed in a hundred years.

If you are comparing bids and one is four thousand dollars cheaper, ask each contractor two questions: how deep are you ripping the subgrade, and how many yards of compost have you allowed. The one who has priced it properly will answer immediately.

Detail L-3.2Bed preparation, section
What is usually sold assoil preparation4" imported mixCompaction panUndisturbed subsoilRoots stop at the pan.What we specifyand price8" amended topsoilcompost incorporatedSubsoil ripped to 18"Undisturbed subsoilRoots still find water in August.
  1. Left — four inches of imported mix spread over ground that a machine has driven on. The plants root into the good layer, meet the compaction pan, and turn sideways. They survive for two or three years on irrigation and then die in the first dry August.
  2. Right — the subsoil is ripped to eighteen inches before anything is imported, so there is no boundary for a root to stop at, then eight inches of amended topsoil over the top.

Hardscape

We lay paving dry on a compacted base and a screeded bed wherever we can, rather than on concrete. Dry-laid stone can be lifted and reset when a root moves it, and on a Portland lot with mature trees something will move it. Mortared paving in the same position cracks and stays cracked.

Basalt, bluestone and reclaimed brick, mostly. All three weather to something better than they started as, which cannot be said of poured concrete.

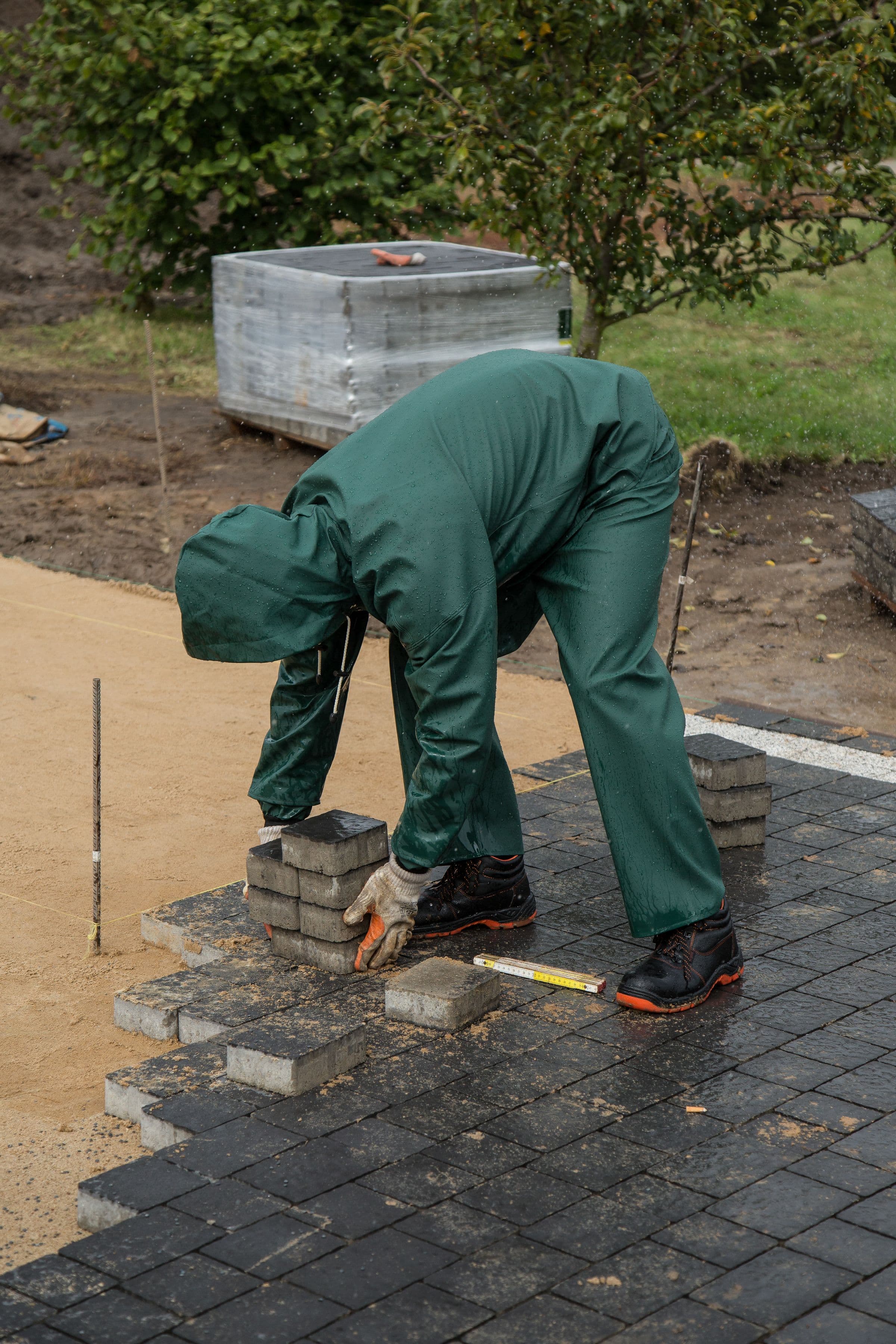

A worker in green waterproofs kneeling to place a paving block against an already-laid course, with a rubber mallet and a stack of blocks beside him on the screeded sand.
Laid dry on sand rather than mortared, so it can be lifted and reset when a root moves it.

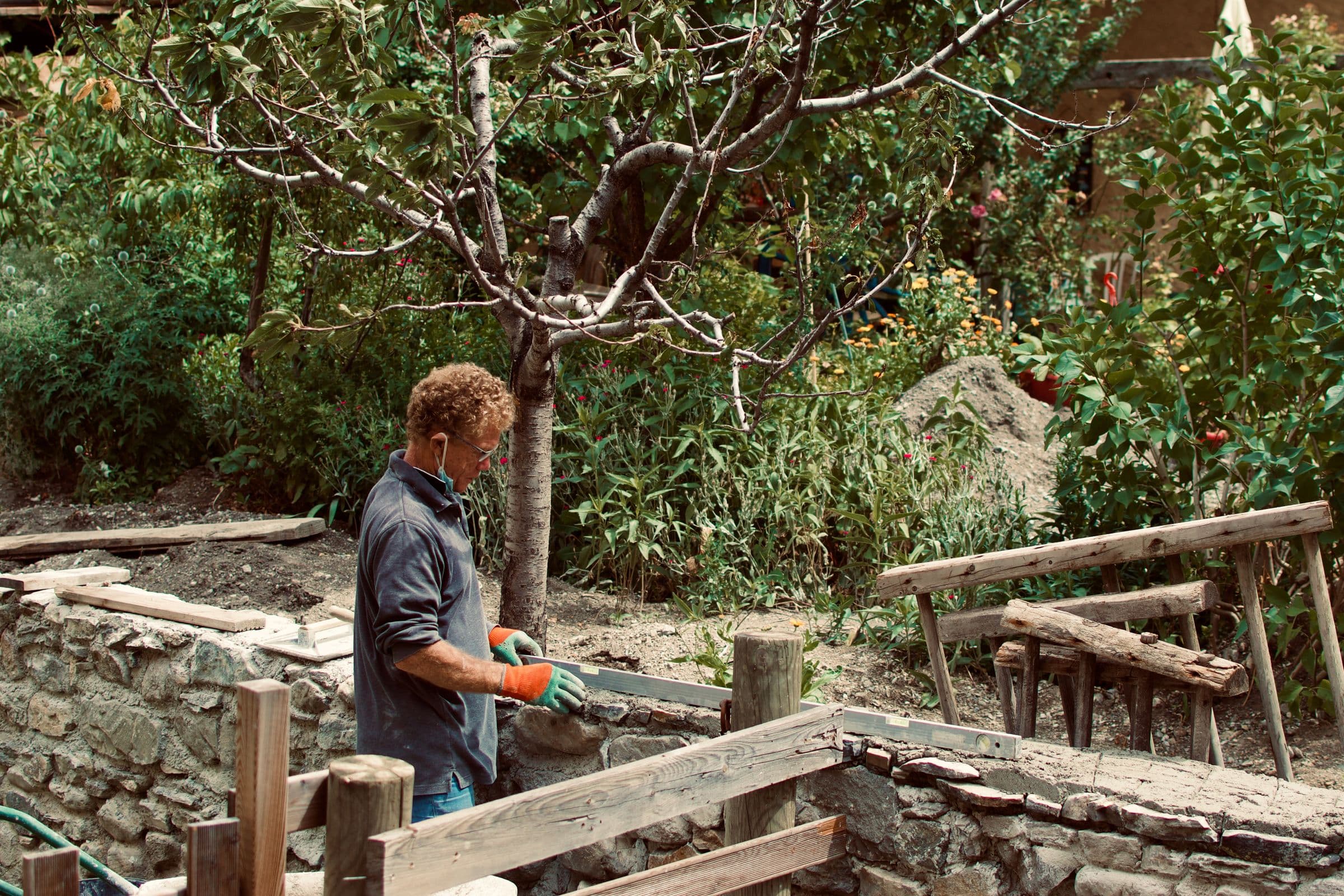

A man in work gloves and a grey shirt building a low stone retaining structure behind timber shuttering in a garden, an old fruit tree and a wheelbarrow behind him, looking down at the stone he is placing.
A retaining wall is a drainage detail that happens to hold soil up.

Irrigation

Drip, on separate zones for woody plants and for perennials, because they want completely different things. Run deep and infrequently — three long soaks a month beats a daily sprinkle, which trains roots to stay at the surface where they will cook.

On most Oregon-side gardens we design irrigation to be reduced every year and switched off around year four, and we say at the outset which plants will still need it after that. In Vancouver, where the soil drains fast and the summers run hotter, it stays.

Planting

We buy small on purpose. A one-gallon Vaccinium ovatum overtakes a five-gallon one inside four years, costs a third as much and roots into the native soil instead of sitting in its own potting mix. The exception is trees, where an extra two years of head start on the canopy is worth paying for.

Rows of young shrubs in black plastic nursery pots standing close together on the ground at a growing nursery, each perhaps two feet tall with thin new growth.
The size most things arrive at. A small plant overtakes a large one inside four years and costs a third as much.

What your garden looks like while we are in it.

Bad. For about three weeks it is bad, and there is no version of this work where it is not. There will be a digger, there will be a spoil heap, there will be a fortnight where the whole thing is churned mud and you will wonder what you have done.

What we can promise is the shape of it. A typical eight-week build runs: one week of demolition and grading, two of drainage and base work, two of hardscape, one of soil, one of planting and one of making good. You get that schedule before you sign, and you get told on the Friday what is happening the following week.

The crew arrives at seven and stops at half past three. They take the road plates up, sweep the street and leave the skip tidy, because your neighbours did not order this and have to live beside it for two months.

A worker in green waterproof trousers and jacket bent double over a string line on a half-laid block paving area, with rain visibly falling, a screeded sand bed to one side and stacked pallets of pavers behind.
Setting a line in October rain. The work stops when the ground freezes, not when the weather turns.
Coarse fresh bark chippings filling the frame, pale tan and dry on top, with fragments of split wood and a few dead leaves caught in the surface.
Year oneForty per cent of a new bed looks like this. That is correct spacing, not a shortage of plants.
